PRINCE2 in Practice: How Structured Project Governance Turns Business Strategy into Controlled Delivery

In a world where organisations are under constant pressure to deliver value faster – with greater control and transparency, structured project governance remains essential. PRINCE2 (Projects IN Controlled Environments) provides exactly that: a process-driven framework used by over a million certified professionals across 150 countries, specifically designed to ensure projects stay aligned with strategic objectives from start to finish.



But PRINCE2 is widely misunderstood. It is often perceived as a bureaucratic overhead and a paper-heavy methodology built for large government programmes.

In reality, it is scalable, easily tailored, and compatible with modern delivery approaches including Agile, Scrum, and hybrid models. When applied thoughtfully, it becomes a mechanism for translating business strategy into controlled, measurable delivery.

This article walks through how each of the seven PRINCE2 processes works in practice with real-world examples, and explains how they collectively protect investment, enforce strategic alignment, and drive benefit realisation.



Why Projects Fail Without Structure



Before diving into the processes, it helps to understand what they are protecting against.

Projects are unique, temporary, and inherently uncertain. Unlike business-as-usual operations, they cross organisational boundaries, involve multi-skilled teams assembled for a fixed period, and introduce change that affects people in ways that are often difficult to predict.

This creates common failure patterns: scope creep, cost overruns, misaligned stakeholder expectations, poor quality handovers, and projects that continue long after the original business rationale has become irrelevant. PRINCE2 directly addresses each of these through its seven integrated processes.

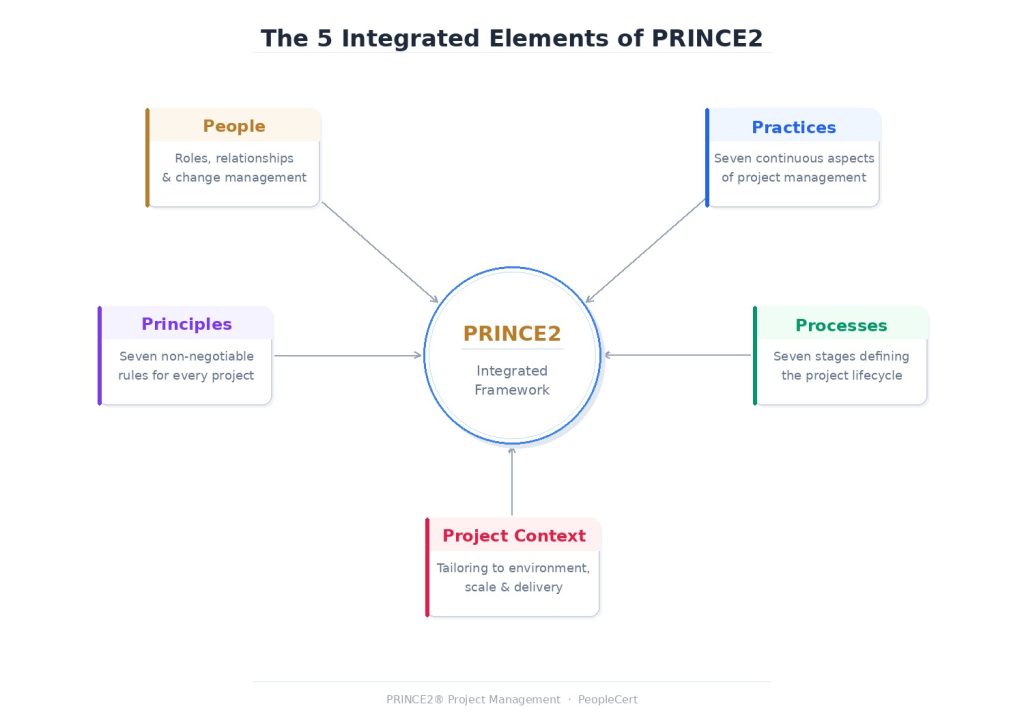

The PRINCE2 Framework: Five Integrated Elements



PRINCE2 is not just a set of processes. It is built on five integrated elements that work together:





coded female





  1. Principles — seven non-negotiable rules that define what makes a project a PRINCE2 project
  2. People — the human dimension: roles, relationships, leadership, and change management
  3. Practices — seven aspects of project management applied continuously (Business Case, Risk, Quality, Plans, Organisation, Issues, Progress)
  4. Processes — seven stages defining the project lifecycle
  5. Project Context — how the method is tailored to fit the specific environment, scale, and delivery approach

The seven processes are the engine of the framework. They define what happens, when it happens, who does it, and what decisions get made at each point in the project lifecycle.

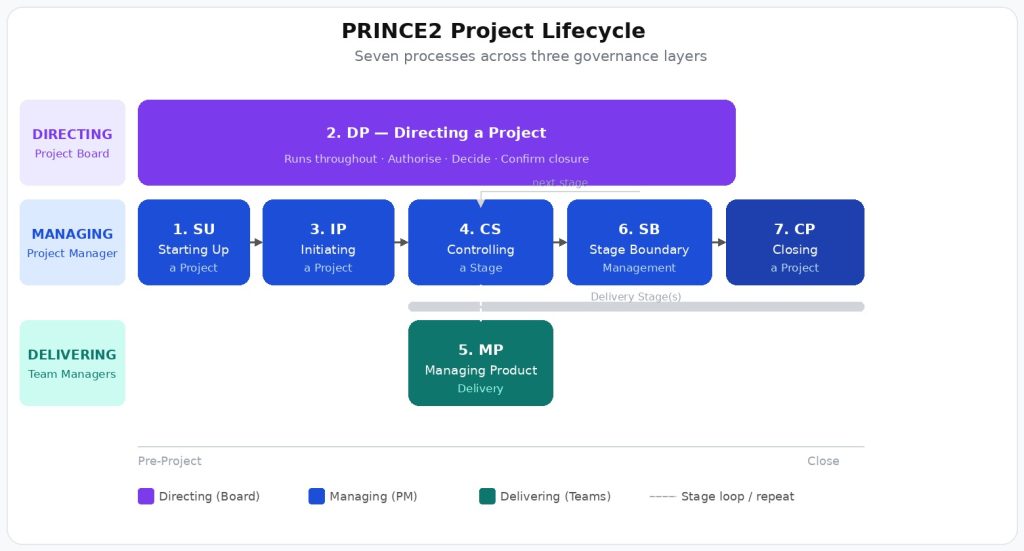

The 7 PRINCE2 Processes: An End-to-End View



PRINCE2 divides the project lifecycle into seven clearly defined processes:

      1. Starting Up a Project (SU)
      2. Directing a Project (DP)
      3. Initiating a Project (IP)
      4. Controlling a Stage (CS)
      5. Managing Product Delivery (MP)
      6. Managing a Stage Boundary (SB)
      7. Closing a Project (CP)



coded female



These processes span three management layers: DIRECTING (Project Board), MANAGING (Project Manager), and DELIVERING (Team Managers). Each layer has distinct responsibilities, and PRINCE2 is explicit about what each level should and should not be involved in — a critical distinction that prevents governance gaps and micromanagement simultaneously.



1. Starting Up a Project (SU)

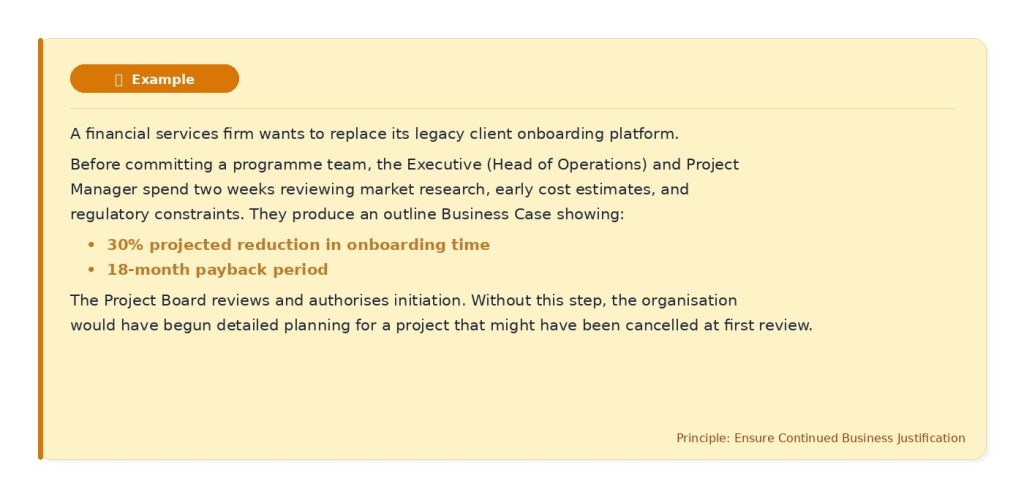

Purpose: Validate the project’s viability before committing significant resources.

This is the pre-project phase. It is not about delivery — it is about asking: Is this worth doing at all?

The key outputs are an outline Business Case, the appointment of the Executive and Project Manager, and a recommendation on whether to proceed to full initiation. The formal output is a Project Brief, which also includes an outline of how PRINCE2 will be applied (tailored) for this specific project.



What happens in practice:

    • The project mandate arrives from the commissioning layer (e.g., a business sponsor or programme board)
    • The Executive is identified — the person ultimately accountable for the project’s business case
    • The Project Manager conducts early-stage due diligence: is there a credible benefit? Do we have access to the right people and resources? Are the risks manageable at this stage?



coded female



Key PRINCE2 principle applied

Ensure continued business justification — the justification must be present before the project even begins.



2. Directing a Project (DP)



Purpose: Enable the Project Board to exercise strategic control without micromanaging delivery.

The Directing a Project process runs from the beginning of initiation all the way through to project closure. It is the mechanism by which the Project Board — comprising the Executive (business accountability), the Senior User (voice of those affected by the outcome), and the Senior Supplier (delivery capability) — remains in control without becoming a bottleneck.

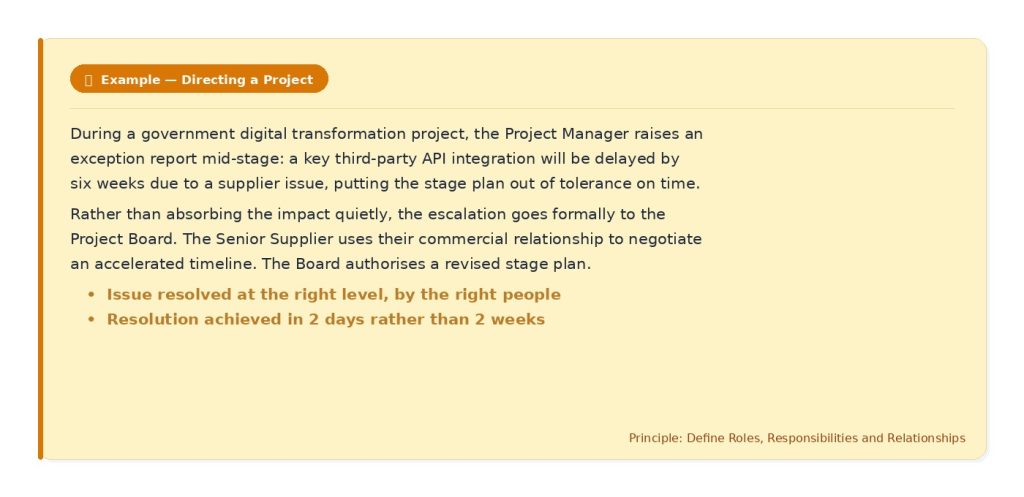

The Project Board does not manage day-to-day activity. Instead, it makes decisions at key control points:

    • Authorise the initiation of the project
    • Authorise each delivery stage
    • Give ad hoc direction when the Project Manager escalates issues
    • Confirm project closure



coded female



Business alignment

The Project Board structure ensures that business, user, and supplier perspectives are all represented in key decisions. This prevents the common failure mode where projects are technically delivered but commercially or operationally useless — because no one with user authority was involved in governance.

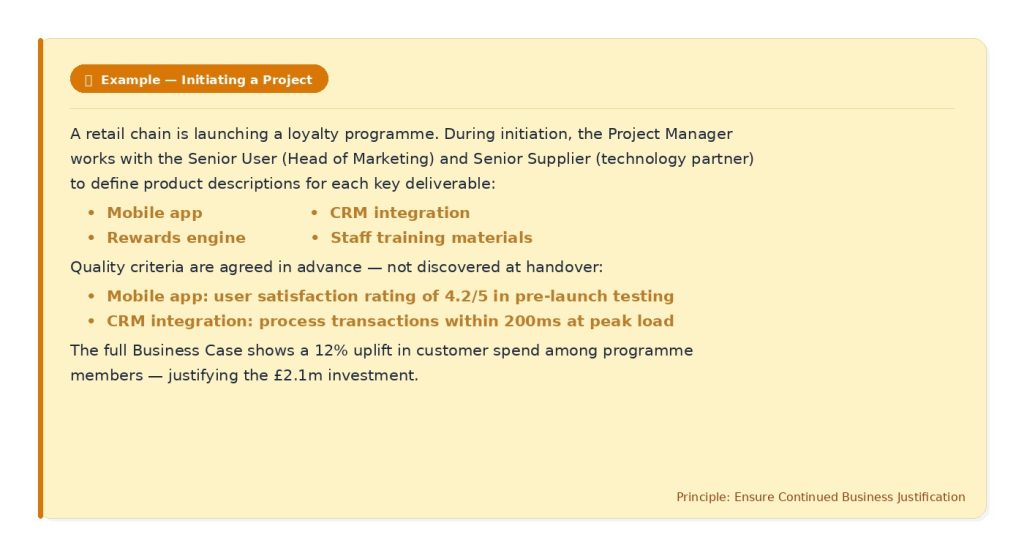

3. Initiating a Project (IP)



Purpose: Establish solid foundations before any delivery begins.

This is where the detailed, structured thinking happens. The Initiation Stage produces the Project Initiation Documentation (PID) — described in PRINCE2 as the “contract” between the Project Board and the project management team. It is the definitive reference point for what the project is, why it exists, how it will be managed, and what success looks like.



The PID brings together:

    • Full Business Case — costs, benefits, timescales, investment appraisal, dis-benefits, and benefit measurement approach
    • Risk Management Strategy — how risks will be identified, assessed, owned, and escalated
    • Quality Management Strategy — what quality means for this project’s products and how it will be assured
    • Communication Management Approach — who needs what information, when, and through which channels
    • Project Plan — the high-level plan showing stages, major milestones, and resource requirements
    • Tailoring decisions — how PRINCE2 is being applied for this specific project





coded female





Why this matters for business alignment

The Business Case becomes the central reference point for every decision made throughout the project. PRINCE2 requires that this justification is not just written once and filed — it must remain valid. This single discipline prevents organisations from continuing to fund projects long after the original rationale has collapsed.

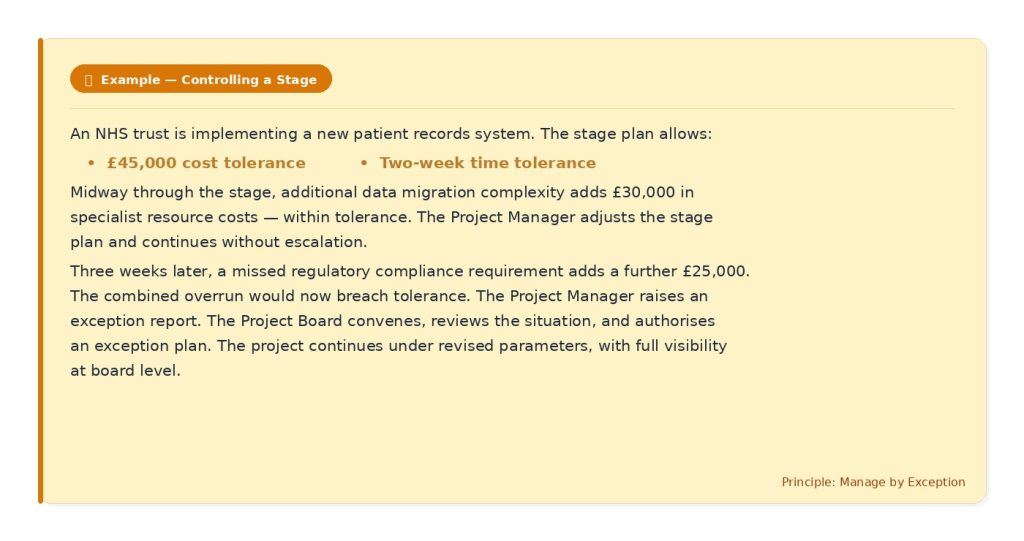

4. Controlling a Stage (CS)



Purpose: Manage the day-to-day delivery of each stage within agreed tolerances.



PRINCE2 divides projects into management stages — defined periods of work with their own plans, objectives, and tolerances. During each stage, the Project Manager runs a continuous cycle of activity:

    • Issue Work Packages to Team Managers, defining what is to be delivered, to what quality, and within what constraints
    • Monitor progress through Checkpoint Reports from teams, and Highlight Reports to the Project Board
    • Capture and assess issues and risks as they emerge
    • Take corrective action within tolerance, or escalate exceptions when tolerance is forecast to be breached



Tolerances are a defining feature of PRINCE2. They are agreed in advance for six dimensions of project performance: time, cost, quality, scope, risk, and benefit. They define the boundaries within which the Project Manager can operate autonomously. If a forecast deviation stays within tolerance — no escalation needed. If it exceeds tolerance — the Project Manager cannot absorb it silently; an exception report goes to the Project Board.



coded female





Business alignment

The tolerance model is where PRINCE2 achieves its most distinctive balance: it empowers teams to move fast and make decisions, while ensuring that anything material is surfaced to the people who are accountable for the investment. It eliminates both micromanagement and uncontrolled drift.



5. Managing Product Delivery (MP)



Purpose: Ensure products are created and delivered to agreed quality standards.

This process describes the work from the Team Manager’s perspective. While the Project Manager operates at the managing layer, Team Managers work at the delivering layer, coordinating the actual creation of products.



The Team Manager:

    • Accepts a Work Package from the Project Manager, negotiating where necessary
    • Plans and executes the work within the team
    • Reports progress via Checkpoint Reports
    • Confirms quality criteria are met before handover



The focus on products — not activities — is central to this process. PRINCE2 is explicit that delivery should be measured by outputs (what was built), not effort (how many hours were spent). Each product has a Product Description defining its purpose, composition, derivation, quality criteria, and quality tolerance — agreed before work begins.



coded female



Business alignment

By tying delivery to pre-agreed quality criteria rather than subjective assessment at handover, PRINCE2 reduces ambiguity and protects value realisation. Products either meet their definition of done, or a conscious decision is made and documented. There is no grey zone.



6. Managing a Stage Boundary (SB)



Purpose: Review stage performance and revalidate the Business Case before authorising the next stage.

This is arguably PRINCE2’s most powerful strategic control mechanism. At the end of every stage (except the final one), the Project Manager completes a structured review and presents the Project Board with everything they need to make an informed decision about whether to continue.



The activities include:

    • Evaluating whether all stage products have been completed and approved
    • Preparing the End Stage Report — performance against the stage plan
    • Updating the Business Case with actual costs, revised forecasts, and updated benefit projections
    • Preparing the next Stage Plan in detail
    • Assessing ongoing viability: are the benefits still achievable? Have risks changed materially?
    • Requesting authorisation to proceed

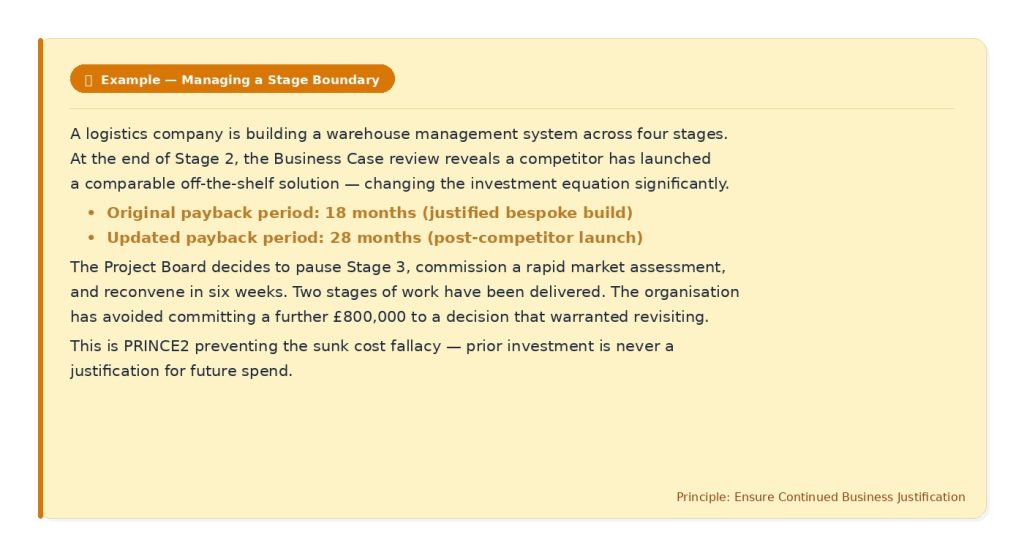

Critically, PRINCE2 is explicit: a positive decision not to proceed is not a failure. Stopping a project at a stage boundary, when the Business Case is no longer valid, is a success of governance — not a project failure.

Exception handling at stage boundaries

If a stage is forecast to go out of tolerance before the planned boundary, the Project Manager raises an Exception Report. The Project Board can direct the preparation of an Exception Plan — which replaces the current stage plan and becomes the new baseline. The exception plan is prepared at the same level of detail as the plan it replaces.



coded female

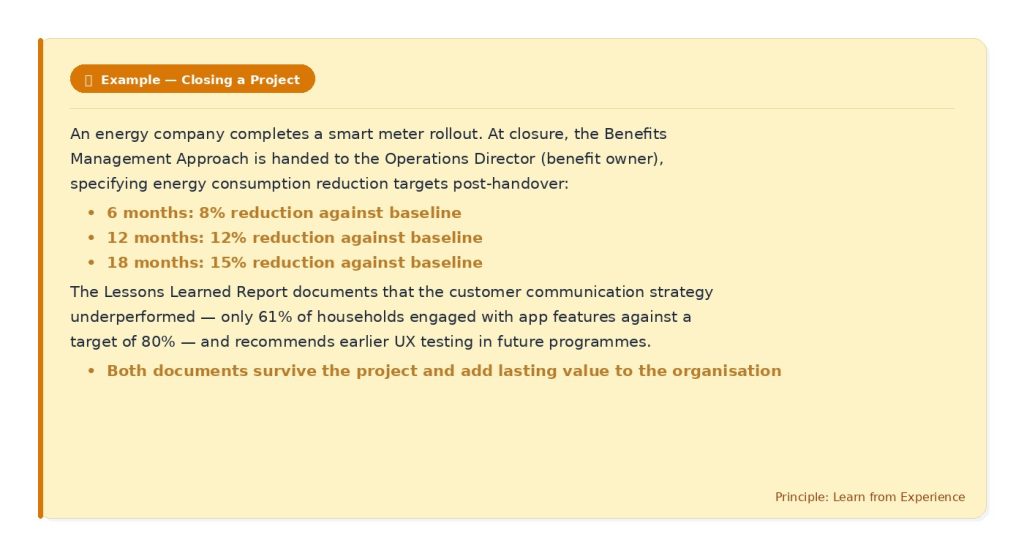

7. Closing a Project (CP)



Purpose: Confirm that objectives have been achieved and ensure that benefits tracking continues beyond delivery.

Closing a Project is not just an administrative sign-off. It is a structured process that prepares the organisation for what happens after the project ends — because in PRINCE2, the project ends when the products are handed over, not when the benefits are realised.



Closure activities include:

    • Handover to operations — products are accepted by the business, with ongoing support and maintenance responsibilities confirmed
    • Benefits Management Approach — updated to reflect what benefits are expected, when they will be measurable, and who owns them post-project
    • Lessons Learned Report — capturing what worked, what did not, and what future projects should do differently
    • End Project Report — final performance against the original Project Initiation Documentation
    • Formal acceptance from the Project Board, who confirm the project may close



The output/outcome/benefit distinction is central here. PRINCE2 is precise about the difference:

    • Output: what the project built — e.g., a new e-commerce platform
    • Outcome: what changed as a result — e.g., customers can now complete purchases without calling the contact centre
    • Benefit: the measurable improvement — e.g., contact centre volume reduced by 22%, saving £340,000 annually



The project delivers the output. The outcome and benefit are realised after closure. The Benefits Management Approach ensures that accountability for realisation does not disappear when the project team disbands.



coded female





How PRINCE2 Integrates With Business Strategy: Five Mechanisms

The seven processes do not operate in isolation. They work together through five structural mechanisms that connect project delivery directly to business objectives.



Continuous Business Justification

The Business Case is not a document written at initiation and archived. It is a living artefact, reviewed at every stage boundary and whenever a significant issue or risk emerges. Every change request, every risk response, every exception is evaluated against a simple question: does this still make business sense? If the answer is no, the project should stop. This creates a form of strategic discipline that most frameworks leave implicit.



Defined Roles and Accountabilities

PRINCE2 is explicit about three levels of accountability. The Project Board is responsible for strategic direction and investment decisions. The Project Manager is responsible for day-to-day delivery management. Team Managers are responsible for product delivery. These layers are not organisational chart titles — they are functional responsibilities. In practice, this prevents the two most common governance failures: senior stakeholders who are not genuinely accountable for outcomes, and project managers who are left to make decisions that should sit at board level.



Stage-Based Control

Breaking projects into stages mirrors the way investment committees and portfolio management boards think. Each stage end is a genuine decision point. The Project Board is not just receiving a progress update — it is deciding whether to commit the funding and resources for the next stage based on current evidence. This enables organisations to manage project investment like a portfolio: incrementally, with risk contained to the approved horizon.



Tolerance-Based Management by Exception

The tolerance model is PRINCE2’s answer to a persistent tension in project governance: how do you maintain control without creating a bottleneck? By pre-agreeing the boundaries within which the Project Manager operates autonomously, the framework eliminates unnecessary escalation while ensuring that material deviations are always surfaced. Senior managers get their time back. The project moves faster. And nothing material is hidden.



Explicit Benefits Focus

Unlike many frameworks that stop at delivery, PRINCE2 tracks expected benefits, names benefit owners, and establishes measurement timelines that extend beyond project closure. This shifts the entire frame of project success from “did we deliver on time and budget?” to “did the organisation realise the value it invested in?” — which is the question that actually matters to boards, sponsors, and shareholders.



PRINCE2 in Modern Organisations: Agile, Hybrid, and Beyond



The most common objection to PRINCE2 in modern delivery environments is that it is too rigid for the pace of change. This objection confuses the framework’s principles (which are fixed) with its application (which is highly flexible).



PRINCE2 explicitly requires tailoring. The Project Manager and Project Board are responsible for deciding, during initiation, how the method will be applied for this specific project. A simple two-stage project might use a single log for risks, issues, and lessons — no separate risk register, no formal exception reports, no stage plans. A complex multi-year programme might use all artefacts in full. Both are valid PRINCE2 implementations, as long as the seven principles are applied.



In practice, many organisations now combine PRINCE2 governance with Agile execution — often called PRINCE2 Agile. The model works like this: PRINCE2 provides the stage gates, the Business Case discipline, the Project Board oversight, and the benefits management framework. Agile (Scrum, Kanban, SAFe) provides the sprint cadence, backlog management, iterative delivery, and cross-functional team structure that operates within the Work Package boundaries.



coded female





This hybrid approach provides strategic control, tactical flexibility, clear accountability, and continuous value tracking — four properties that are individually achievable and collectively rare.

The Three Questions PRINCE2 Always Answers

At its core, PRINCE2 exists to keep three questions permanently in view throughout the project lifecycle:



Is this initiative still worth doing?

The Business Case, reviewed at every stage boundary and whenever circumstances change materially, prevents organisations from continuing to invest in projects that have lost their business rationale.



Are we delivering the right outcomes?

Product Descriptions, quality criteria, and the Senior User’s representation on the Project Board ensure that what is being built matches what the business and users actually need — not what was assumed at initiation.



Are we achieving measurable benefits?

The Benefits Management Approach, the output/outcome/benefit distinction, and named benefit owners ensure that accountability for value realisation extends beyond the project closure date.

When applied thoughtfully, PRINCE2 is less about control — and more about clarity. And in complex organisations delivering ambitious change, clarity is a genuine competitive advantage.
